Not every garment produced in a factory passes quality inspection the first time.
During bulk production, some pieces may have problems such as:
-
Open seams
-
Skipped stitches
-
Wrong measurements
-
Loose threads
-
Stains
-
Print defects
-
Zipper problems
-
Label mistakes
-
Fabric damage
Some of these garments can be corrected.
Others may be too defective to repair and must be rejected.
This is why garment factories use a structured process for rework, repair, rejection, and final reinspection before dispatch.
For clothing brands, buyers, merchandisers, quality teams, and manufacturers, understanding this process is important because poor control of defective pieces can lead to customer complaints, shipment rejection, returns, and damage to brand reputation.
This guide explains how garment factories identify defective garments, decide whether they can be repaired, control rework, segregate rejected pieces, and ensure only acceptable garments are packed for shipment.
What Is Rework in Garment Manufacturing?
Rework means correcting a garment that has a defect but can still be brought back within the approved quality standard.
For example:
A side seam has opened slightly.
The garment may be returned to the sewing operator for correction.
After repair, it is inspected again.
If it meets the approved standard, it can continue to finishing and packing.
What Is Garment Repair?
Repair is closely related to rework.
It usually refers to fixing a specific quality problem.
Examples include:
-
Restitching an open seam
-
Replacing a button
-
Fixing a zipper
-
Removing stains
-
Correcting a label
-
Reattaching a loose trim
The repaired garment must still meet the original product specification.
What Is a Rejected Garment?
A rejected garment is a piece that does not meet the required quality standard and cannot be corrected economically or safely.
Examples may include:
-
Major fabric hole
-
Permanent stain
-
Incorrect cut
-
Severe measurement problem
-
Damaged print
-
Wrong fabric
-
Irreparable stitching damage
Rejected pieces should be separated from approved production.
Rework vs Repair vs Rejection
These terms are related but different.
| Term | Meaning |
|---|---|
| Rework | Garment is corrected and returned to production flow |
| Repair | Specific defect is physically fixed |
| Reject | Garment cannot be accepted or corrected properly |
The key difference is whether the garment can still meet the approved standard after correction.
Why Rework Control Is Important
Poorly controlled rework can create several problems.
These include:
-
Defective garments entering packing
-
Repeat defects
-
Production delays
-
Higher labour cost
-
Wrong shipment quantity
-
Buyer rejection
Factories therefore need a clear system for handling non-conforming garments.
Where Rework Can Happen
Rework can occur at several production stages.
Common areas include:
-
Cutting
-
Printing
-
Embroidery
-
Sewing
-
Finishing
-
Final inspection
-
Packing
The earlier a defect is found, the easier and cheaper it usually is to correct.
1. Cutting Rework
Some cutting defects may be corrected before sewing.
Examples include:
-
Incorrect notch
-
Misaligned panel
-
Wrong size marking
If a panel is cut incorrectly, the factory may need to recut the piece.
If additional fabric is unavailable, the garment may become a rejection.
2. Printing Rework
Print defects may include:
-
Wrong placement
-
Incomplete print
-
Colour mismatch
-
Cracking
-
Smudging
Some printing defects can be corrected.
Others cannot.
For example, a severely misaligned screen print may make the garment unusable.
3. Embroidery Rework
Embroidery defects may include:
-
Wrong thread colour
-
Loose stitches
-
Incorrect placement
-
Puckering
-
Missing embroidery
Minor issues may be repairable.
Major embroidery damage may require panel replacement or garment rejection.
4. Sewing Rework
Sewing is one of the most common areas for rework.
Typical sewing defects include:
-
Open seam
-
Skipped stitch
-
Broken stitch
-
Uneven seam
-
Incorrect stitch type
-
Wrong label attachment
-
Puckering
These garments are usually returned to a designated repair station.
5. Finishing Rework
Finishing defects may include:
-
Loose threads
-
Poor pressing
-
Stains
-
Chalk marks
-
Dust
-
Wrinkles
Many finishing defects are relatively easy to correct.
However, stains that cannot be removed may lead to rejection.
6. Packing Rework
Packing mistakes can also require rework.
Examples include:
-
Wrong size sticker
-
Wrong barcode
-
Wrong polybag
-
Missing hang tag
-
Incorrect folding
The garment itself may be fine, but the packaging must be corrected before shipment.
How Factories Identify Defective Pieces
Quality inspectors check garments at several stages.
These may include:
-
Inline inspection
-
End-line inspection
-
Finishing inspection
-
Final inspection
Any garment that does not meet the approved standard is separated.
It should not continue automatically to the next stage.
Defect Tagging
Factories may attach a defect tag or sticker to the garment.
The tag may indicate:
-
Defect type
-
Operation
-
Inspector
-
Date
-
Repair required
For example:
Defect: Open Side Seam
Action: Restitch & Recheck
This helps the repair team understand what needs to be corrected.
Segregation of Defective Garments
Defective garments should be physically separated from good pieces.
Factories may use different bins or racks marked:
-
PASS
-
REWORK
-
REJECT
-
HOLD
This reduces the risk of mixing defective garments with approved goods.
What Does "Hold" Mean?
A garment may be placed on hold when the quality team is not yet sure whether it should be accepted or rejected.
For example:
A colour shade may need buyer approval.
Until a decision is made, the piece should remain separated.
Common Garment Defects That Can Be Reworked
Many minor or medium defects can be corrected.
Examples include:
-
Open seam
-
Loose stitch
-
Missing stitch
-
Untrimmed thread
-
Loose button
-
Incorrect label attachment
-
Light removable stain
-
Minor pressing issue
-
Packaging mistake
After correction, the garment must be inspected again.
Defects That May Lead to Rejection
Some defects are difficult or impossible to repair.
Examples include:
-
Fabric hole
-
Permanent oil stain
-
Severe print damage
-
Wrong fabric panel
-
Incorrect cut
-
Large measurement deviation
-
Severe needle damage
-
Irreparable colour variation
These garments should not be shipped as first-quality products.
What Is First-Pass Quality?
First-pass quality measures how many garments pass inspection without requiring rework.
For example:
1,000 garments inspected
900 pass immediately
100 require rework
First-pass quality:
900 ÷ 1,000 × 100
= 90%
Higher first-pass quality usually means better production control.
Why First-Pass Quality Matters
High rework levels indicate problems in the production process.
These may include:
-
Poor operator training
-
Machine setting issues
-
Weak quality control
-
Incorrect methods
Factories should focus on preventing defects rather than repeatedly repairing them.
Rework Rate
A simple rework rate can be calculated as:
Reworked Pieces ÷ Pieces Inspected × 100
Example:
500 garments inspected
50 require rework
Rework rate:
50 ÷ 500 × 100
= 10%
This helps factories track quality performance.
Rejection Rate
Rejection rate can be calculated as:
Rejected Pieces ÷ Total Produced × 100
Example:
5,000 garments produced
50 rejected
Rejection rate:
50 ÷ 5,000 × 100
= 1%
High rejection rates can cause significant financial loss.
Why Rework Is Expensive
Rework uses additional:
-
Labour
-
Machine time
-
Inspection time
-
Electricity
-
Handling
The garment has already consumed production resources once.
Repairing it increases the actual cost per garment.
Example of Rework Cost
Suppose:
500 garments need repair.
Average repair cost:
₹10 per garment
Total additional cost:
500 × ₹10
= ₹5,000
This does not include delay or inspection cost.
At large production volumes, rework can become expensive.
Rework Can Also Reduce Production Capacity
Operators repairing old garments are not producing new garments.
This reduces available production time.
Therefore, high rework can lower:
-
Productivity
-
Line efficiency
-
Daily output
Quality and efficiency are closely connected.
Rework Station
Many factories create a designated rework station.
This may include:
-
Sewing machine
-
Trimming table
-
Stain-removal area
-
Inspection table
Defective garments are sent there instead of returning randomly to the production line.
Why a Separate Rework Area Helps
A controlled repair area helps:
-
Track defective pieces
-
Prevent mixing
-
Assign responsibility
-
Maintain records
-
Recheck repaired garments
This creates better production discipline.
Reinspection After Repair
A repaired garment should never go directly to packing.
It must be reinspected.
The inspector checks:
-
Was the original defect corrected?
-
Did the repair create another defect?
-
Does the garment now meet specification?
Only then should the piece be marked as passed.
Rework Flow
A simple process is:
Defect Found → Garment Segregated → Defect Tagged → Repair → Reinspection → Pass or Reject
This cycle may repeat if the garment still fails.
Avoid Repeated Rework
A garment should not be repaired repeatedly without control.
Multiple repairs can:
-
Damage fabric
-
Create needle holes
-
Affect appearance
-
Reduce strength
Factories should define when a garment should be rejected instead of continuing to repair it.
Root Cause Analysis
If the same defect appears repeatedly, the factory should not simply repair every garment.
It should identify the cause.
For example:
Repeated skipped stitches may be caused by:
-
Wrong needle
-
Machine timing
-
Thread problem
-
Operator technique
Correcting the root cause prevents additional defects.
Corrective Action
Corrective action may include:
-
Machine adjustment
-
Operator training
-
Method change
-
New needle
-
Pattern correction
-
Material replacement
The goal is to stop the defect from recurring.
Preventive Action
Preventive action goes one step further.
It asks:
How can we stop this problem from happening again on future orders?
This may lead to:
-
Updated SOP
-
New quality checkpoint
-
Better training
-
Improved machine maintenance
Rework During Inline Inspection
Inline inspection is the best stage for controlling rework.
Why?
Because defects are identified while production is still running.
If one operator is creating an open seam defect, the factory can correct the issue before hundreds of garments are affected.
Rework During End-Line Inspection
At end-line inspection, complete garments are checked after sewing.
Pieces requiring repair are separated before finishing.
This prevents defective garments from moving deeper into the production process.
Rework During Final Inspection
Final inspection happens close to shipment.
At this stage, any defect can become more serious because there is less time for repair.
This is why relying only on final inspection is risky.
Defect Classification
Factories and buyers may classify defects as:
-
Critical
-
Major
-
Minor
This helps determine the required action.
Critical Defect
A critical defect may create:
-
Safety risk
-
Legal risk
-
Serious product failure
These defects may require immediate rejection or escalation.
Major Defect
A major defect significantly affects:
-
Fit
-
Appearance
-
Function
-
Saleability
Examples may include:
-
Broken zipper
-
Large measurement error
-
Open seam
Minor Defect
A minor defect may have limited impact on product use.
Examples include:
-
Small thread tail
-
Minor cosmetic variation
Even minor defects should be controlled if they appear repeatedly.
What Happens to Rejected Pieces?
Factories should have a clear policy.
Rejected pieces may be:
-
Stored separately
-
Recorded
-
Destroyed
-
Downgraded
-
Used for internal purposes
The exact process depends on buyer agreement and company policy.
Why Rejected Garments Must Be Controlled
If branded rejected pieces leave the factory uncontrolled, they may:
-
Enter unauthorized markets
-
Damage brand reputation
-
Create counterfeit confusion
Brands may require destruction or removal of identifying labels before disposal.
Second-Quality Garments
Some factories or brands classify certain pieces as second quality.
These garments may have small cosmetic defects but remain usable.
However, they should only be sold as second quality if this is allowed by the brand or buyer.
They should never be mixed with first-quality shipment.
Rejected Quantity and Shipment Quantity
Suppose the PO requires:
10,000 pieces
But:
100 pieces are rejected.
The factory may need to produce replacement pieces to complete the order.
This is why factories often plan a small production allowance.
Production Allowance
Factories may cut or produce a small extra quantity to cover:
-
Damage
-
Rejection
-
Testing
However, extra production should be controlled.
The buyer may not accept unauthorized excess shipment.
Replacement Production
If rejection levels are high, the factory may need to:
-
Recut panels
-
Restitch garments
-
Reprint
-
Repack
This can delay shipment.
Rework and T&A Calendar
Rework can affect the Time and Action calendar.
For example:
Sewing completion planned:
10 Oct
Unexpected rework:
2 days
Final inspection may move to:
12 Oct or later
This is why buyers should monitor quality before shipment week.
Rework Reports
Factories may maintain a rework report.
Example:
| Defect | Rework Qty | Reject Qty |
|---|---|---|
| Open Seam | 35 | 0 |
| Skipped Stitch | 22 | 0 |
| Stain | 15 | 5 |
| Print Damage | 4 | 10 |
This helps identify problem areas.
Pareto Analysis for Defects
Factories may use Pareto analysis to identify the most frequent defects.
For example:
-
Open seam = 40%
-
Skipped stitch = 25%
-
Stain = 15%
-
Others = 20%
The factory can focus first on the biggest defect source.
Rework Responsibility
Responsibility may depend on where the defect originated.
For example:
-
Sewing defect → Sewing department
-
Print defect → Printing unit
-
Fabric defect → Fabric supplier
-
Label defect → Trim supplier
Clear responsibility helps improve corrective action.
Repair Quality
A repair should not look like an obvious repair.
For example:
Restitched seams should not create:
-
Extra stitch lines
-
Visible needle holes
-
Uneven appearance
The repaired garment should meet the same standard as first-pass production.
Measurement Rework
Measurement problems are more difficult to fix.
For example:
Sleeve too long may sometimes be corrected.
But chest too narrow may be impossible to repair.
This is why measurement control during sewing is important.
Stain Removal
Some factories have stain-removal stations.
Minor marks may be treated carefully.
However, harsh cleaning can:
-
Change colour
-
Damage fabric
-
Leave marks
The garment must be inspected after cleaning.
Thread Trimming Rework
Loose threads are among the easiest defects to correct.
Finishing teams usually trim:
-
Seam threads
-
Label threads
-
Embroidery threads
This should be completed before packing.
Label Rework
If a wrong size label is attached, it may be removed and replaced.
However, removal should not damage:
-
Seam
-
Fabric
-
Main label
Label accuracy is especially important for retail orders.
Zipper Repair
A defective zipper may sometimes be replaced.
But replacement can be time-consuming.
Repeated zipper problems may indicate:
-
Poor trim quality
-
Incorrect attachment
The root cause should be investigated.
Button Repair
Loose or missing buttons are commonly repaired.
The replacement button must match:
-
Size
-
Colour
-
Material
Button strength should also be checked.
Print Repair Limitations
Print defects are often harder to repair than sewing defects.
For example:
A missing small area might sometimes be corrected.
But a large misaligned print may require rejection.
This is why bulk print approval is important before mass production.
Packing Rework
Packing issues can usually be corrected.
Examples include:
-
Wrong barcode
-
Wrong size sticker
-
Missing hang tag
-
Wrong folding
The packing team should recheck corrected cartons.
Final Audit Before Dispatch
Before dispatch, the factory should verify:
-
Rework is completed
-
Repaired garments passed inspection
-
Rejects are separated
-
Shipment quantity is correct
-
Packing is correct
This reduces the risk of defective goods reaching the buyer.
AQL and Reworked Pieces
Final inspection may use AQL sampling.
Reworked garments still need to meet the same approved quality standard.
A repaired piece should not receive a lower quality standard simply because it was corrected.
Rework and Buyer Communication
If rework becomes significant, the supplier should inform the buyer.
Important issues may include:
-
Quantity shortage
-
Shipment delay
-
Major quality problem
Early communication gives the buyer more options.
What Buyers Should Ask About Rework
Buyers can ask:
-
What is the current rework rate?
-
What are the top defects?
-
How many pieces are rejected?
-
What corrective action was taken?
-
Will shipment quantity be affected?
These questions provide a clearer picture of production quality.
How Buyers Can Reduce Rework Risk
Approve a Clear PP Sample
Factories need a physical quality standard.
Provide a Detailed Tech Pack
Clear instructions reduce mistakes.
Approve Fabric and Trims
Avoid material substitutions.
Monitor Inline Quality
Do not wait until final inspection.
Track Defect Trends
Repeated defects need corrective action.
Rework and Small Clothing Brands
Small brands should not ignore rework.
If a startup produces only:
200 T-shirts
and 30 pieces are rejected,
that is:
15% of the entire order.
Small production runs can be heavily affected by quality loss.
Example Rework Process
Imagine a factory produces:
5,000 T-shirts.
Inline inspection finds:
100 open seams
50 skipped stitches
20 stained garments
The factory may:
-
Send open seams for restitching.
-
Send skipped stitches for repair.
-
Send stained pieces for cleaning.
-
Reinspect all corrected garments.
-
Reject any pieces that still fail.
-
Replace rejected quantity if required.
-
Proceed to final inspection.
This is a controlled rework process.
How Rework Affects Garment Costing
High rework increases:
-
Labour cost
-
Inspection cost
-
Production time
Therefore, factories may have lower profit if defect rates are high.
Better quality at first pass is usually more economical than repeated repair.
How Rework Affects Delivery
Repair work takes time.
If defects are discovered late, shipment may need to be postponed.
This is why quality should be controlled throughout production.
Prevention Is Better Than Rework
The strongest factories focus on:
-
Correct method
-
Proper machine setup
-
Operator training
-
Inline inspection
-
Good materials
The goal should be:
Make it right the first time.
Rework should be a backup process, not the normal production method.
Common Mistakes in Rework Control
1. Mixing Rework With Passed Garments
Always segregate.
2. No Defect Tag
Repair teams need clear instructions.
3. No Reinspection
Every repaired garment must be checked again.
4. Repeated Repair Without Rejection Criteria
Some pieces should be rejected instead.
5. No Root Cause Analysis
Fixing garments without fixing the process allows defects to continue.
Rework Control Checklist
Before shipment, confirm:
-
Defective pieces segregated
-
Defect type recorded
-
Repair completed
-
Reinspection completed
-
Reject quantity recorded
-
Replacement quantity completed
-
Packing quantity verified
-
Final inspection passed
This helps prevent defective garments from reaching the customer.
Frequently Asked Questions
What is rework in garment manufacturing?
Rework is the process of correcting a garment defect so the product can meet the approved quality standard.
What is the difference between rework and rejection?
Rework means the garment can be corrected.
A rejected garment cannot be accepted or repaired properly.
Can all garment defects be repaired?
No.
Some defects such as severe fabric damage, incorrect cutting, or permanent print damage may require rejection.
Should repaired garments be inspected again?
Yes.
Every repaired garment should be reinspected before packing.
What happens to rejected garments?
They are segregated and handled according to the factory and buyer's rejection policy.
Why is high rework a problem?
It increases labour cost, reduces productivity, and can delay shipment.
What is first-pass quality?
It is the percentage of garments that pass inspection without needing rework.
Can rework affect shipment quantity?
Yes.
If too many pieces are rejected, the factory may need to produce replacements.
Final Thoughts
Rework, repair, and rejection are normal parts of garment quality control, but they must be carefully managed.
A strong factory does not simply repair defects randomly.
It follows a controlled system:

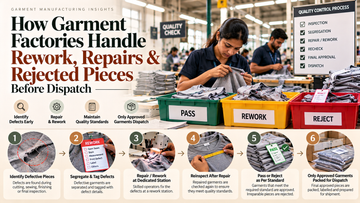

Defect Identification → Segregation → Repair → Reinspection → Pass or Reject
The most important goal is not to become better at repairing garments.
It is to reduce the number of defects created in the first place.
That requires:
-
Good materials
-
Correct machines
-
Skilled operators
-
Clear specifications
-
Inline quality control
-
Root cause analysis
For apparel buyers and clothing brands, monitoring rework levels can provide valuable insight into factory performance.
The best-quality garment is not the one repaired perfectly at the end—it is the one produced correctly the first time.
